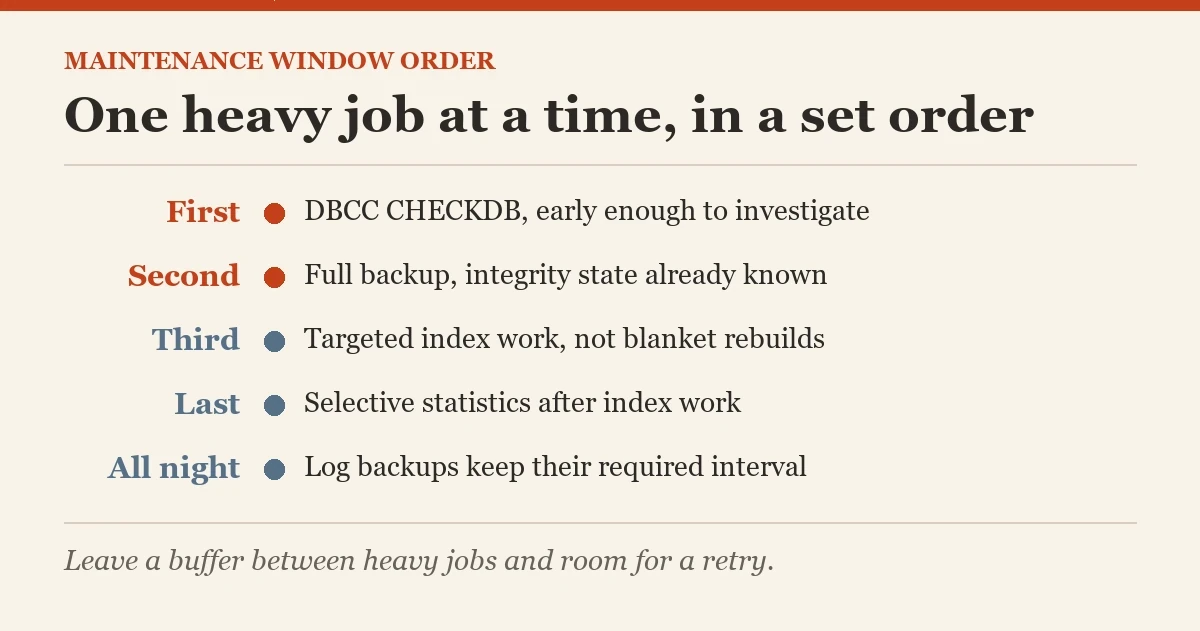

Four heavy jobs starting at the same hour can turn a quiet maintenance window into an IO contest. A maintenance window works better when integrity checks, backups, and index work have an explicit order.

Put Every Maintenance Window Job on One Page
List SQL Agent jobs, enabled state, schedules, and next run times. Review job steps too; a job named "cleanup" can run DBCC CHECKDB, while another named "backup" can include compression and verification. I compare the schedule with actual run history because jobs can drift past their start times. If several jobs share one schedule, note that relationship. A calendar makes overlap obvious before it becomes a production complaint. A next_run_date of 0 means Agent has no upcoming run recorded, as with the disabled schedules on my test server.
SELECT j.name AS job_name, j.enabled, sc.name AS schedule_name,
sc.enabled AS schedule_enabled, js.next_run_date, js.next_run_time
FROM msdb.dbo.sysjobs AS j
LEFT JOIN msdb.dbo.sysjobschedules AS js ON js.job_id = j.job_id
LEFT JOIN msdb.dbo.sysschedules AS sc ON sc.schedule_id = js.schedule_id
ORDER BY j.name, sc.name;Protect Integrity Work
DBCC CHECKDB can create substantial IO and tempdb work. Put it early enough that a failure can be investigated, and do not overlap it with another heavy scan or rebuild on the same storage. The order in this post places CHECKDB before the full backup, so the team knows the database's integrity state before that backup is taken. A failed CHECKDB must raise an alert. It must not silently cancel every later backup. I keep the backup schedule running while the integrity problem is handled, since losing backup coverage compounds the incident.
On large databases, CHECKDB can exceed the available window. Test duration on restored copies, consider documented physical-only or staggered strategies only under a clear policy, and keep full integrity coverage on a known cadence.
Give Backups Their Own Capacity
Full backups read the database and write compressed backup data. Log backups keep recovery coverage and should continue on their required interval, even during other maintenance. Avoid starting a full backup at the same time as CHECKDB and a rebuild when they share IO paths. I measure actual job durations and throughput rather than reserving the same fixed hour forever. Verify backup completion and restore ability. A successful Agent job can still write media that nobody has restored.
Record dependencies such as offsite copy and verification. If backup files must be shipped before business hours, the window ends after that transfer, not after BACKUP DATABASE returns.
Place Index Work Before Statistics
Target index maintenance to objects that need it. Blanket rebuilds waste time, log, and storage. A rebuild updates statistics for that index, while other statistics can remain stale. Schedule selective statistics updates after index work so they reflect the final structure and data state. I also check whether a rebuild is resumable or online under the installed edition and specific operation. Do not add those options to every command without testing. Keep enough free log and tempdb capacity for the planned work.
What happens when one task runs long? Define which optional work gives way first. Backups and integrity coverage should not be squeezed out by cosmetic index maintenance.

Track Maintenance Window Duration as Databases Grow
Collect job start, finish, and outcome from Agent history and compare them with the allowed window. A trend matters more than one unusually slow night. The query below shows recent whole-job outcomes and duration in Agent's encoded format. Convert that duration for reporting, and pair it with database size and IO context. I look for jobs that steadily consume more of the available window, then split or reschedule them before they collide.
SELECT TOP (100) j.name, h.run_date, h.run_time,
h.run_duration, h.run_status, h.message
FROM msdb.dbo.sysjobhistory AS h
JOIN msdb.dbo.sysjobs AS j ON j.job_id = h.job_id
WHERE h.step_id = 0
ORDER BY h.instance_id DESC;Separate Mandatory Work From Optional Work

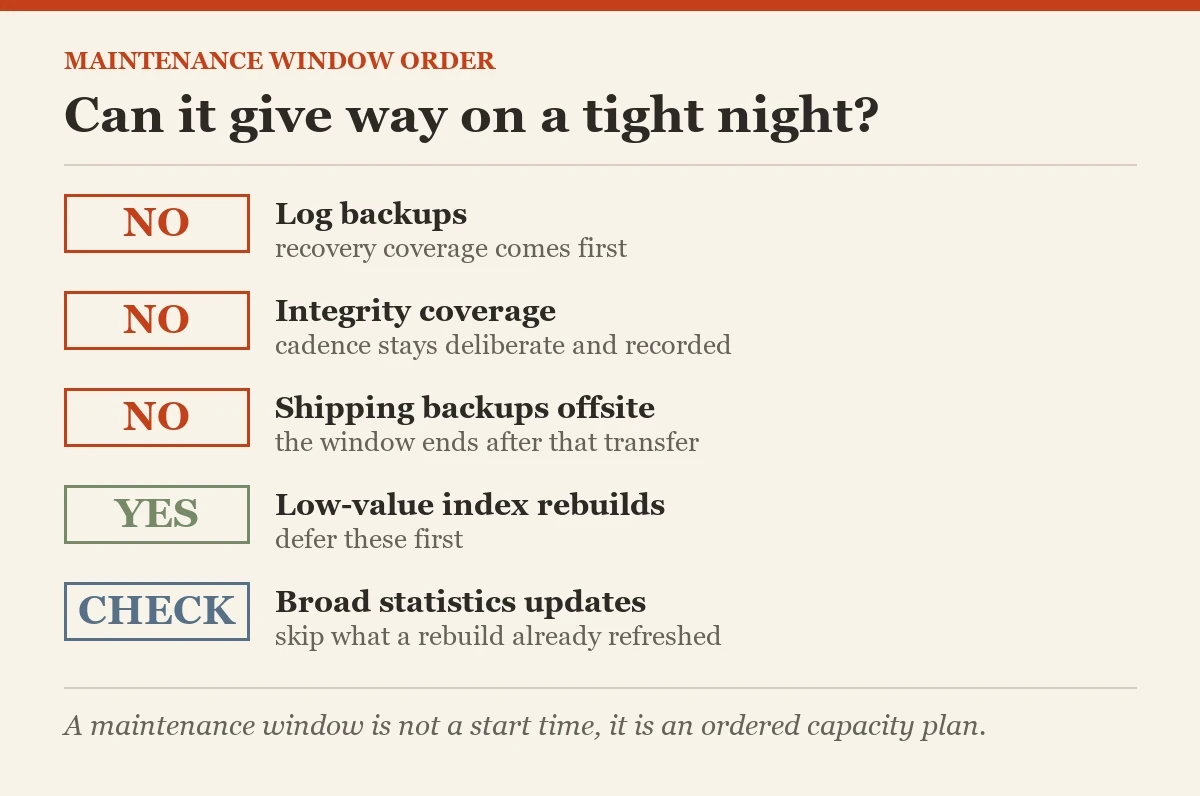

Backups and integrity checks protect recovery and correctness. Index maintenance and broad statistics updates support performance, but their frequency and scope should follow evidence. I rank tasks before scheduling them. If the window shrinks, I defer low-value rebuilds before I skip a required log backup or leave a database without integrity coverage. This does not mean CHECKDB must run every night for every database; it means its cadence is deliberate and recorded. A scheduled task that never completes within its slot has no useful schedule.
I also inspect whether a full backup causes log backup delays or whether an index rebuild fills the log faster than backups can clear it. The jobs can have different start times and still overlap because one runs long. Actual finish times belong on the calendar.
Build a Growth Trigger
Set a review trigger based on job duration approaching the end of the allowed window, database growth, or repeated overlap. I prefer an alert before the first business-hours collision. Split CHECKDB coverage across nights when the policy allows, or move a large backup to a storage path with adequate throughput. Replace blanket index rebuilds with targeted work. Keep statistics updates after index work where that order is chosen, but avoid duplicating statistics already refreshed by a rebuild.
What happens when a task fails halfway? The next job should not blindly start heavy work without checking status. Use Agent job dependencies or a coordinating schedule with explicit success and failure branches. I record the decision in a short runbook: which task retries, which task alerts, and which task proceeds despite the failure. That turns a crowded 1 AM start time into a managed sequence.
Leave a small buffer between heavy jobs instead of packing the schedule to the minute. Backup compression, CHECKDB, and index work vary with data growth and competing activity. I use observed duration ranges from job history and keep room for a retry. A maintenance window with no slack can fail even when every individual job is healthy.
Leave a Clear Recovery Rule for the Maintenance Window
Document the normal order, max duration, alert owner, and what to skip when the window is tight. A failed CHECKDB calls for investigation, not an automatic repair command. A failed backup calls for another backup and restore-chain review. A delayed statistics job is usually less urgent. I rehearse those decisions in the runbook because at 4 AM every job claims to be essential.
The schedule should be reviewed after database growth, new workloads, and storage changes. A maintenance plan that fit last quarter can run into business hours now. Treat the window as a limited resource and spend it on the tasks that protect recoverability and correctness first.
Related reading on this blog: Your Index Rebuild Maintenance Plan Is Rebuilding Indexes Nobody Uses and SQL Server Maintenance Techniques: A Comprehensive Guide to Keeping Your Server Running Smoothly.

A maintenance window is not a start time, it is an ordered capacity plan.
